Critical Buying Tips for Steel Floor Deck for Your Next Building Project
Home » News » Critical Buying Tips for Steel Floor Deck for Your Next Building Project

Critical Buying Tips for Steel Floor Deck for Your Next Building Project

Views: 0     Author: Site Editor     Publish Time: 2026-08-28      Origin: Site

Inquire

facebook sharing button
twitter sharing button
line sharing button
wechat sharing button
linkedin sharing button
pinterest sharing button
whatsapp sharing button
sharethis sharing button

Critical Buying Tips for Steel Floor Deck for Your Next Building Project

Introduction: Why Your Steel Floor Deck Decision Matters

Walk under any modern parking garage, commercial mezzanine, or multi-story office building and look up. That corrugated ribbed metal sheet bonded to the concrete above is doing far more structural work than most people realize. Steel floor deck serves as both permanent formwork for wet concrete and as tension reinforcement for the cured slab. It is, quite literally, the foundation upon which your building's floor system rests.

Selecting the right steel floor deck is one of the most consequential—and frequently underestimated—decisions in the structural design of any commercial or industrial building. The deck you choose determines not only how the floor system performs structurally, but also how quickly and efficiently the project can be completed. With multiple profiles, gauges, finishes, and sourcing options available, understanding the differences helps contractors, engineers, and building owners make confident, cost-effective choices.


This guide provides critical buying tips grounded in industry standards, real data, and decades of engineering practice. Whether you are specifying for a high-rise office tower, a warehouse, or a residential addition, these principles will help you navigate the procurement process with confidence.

Open Type Floor Decking HY51-250-750 - HongYe

Part 1: Understanding What Steel Floor Deck Is and How It Works

Steel floor deck is a roll-formed sheet of galvanized steel, typically 22 to 16 gauge thick, with corrugations that create longitudinal ribs across the width. The ribs add bending stiffness, allowing the deck to span between joists or beams without intermediate support during the concrete pour. Once concrete is placed and cures, the deck becomes part of a composite floor structure. Embossments stamped into the side walls of each rib create mechanical interlock with the concrete, so the steel and concrete act as one structural unit under load. This combined system can span 10 to 14 feet between supports while carrying 100 to 250 pounds per square foot of live load.

Key terminology to know:

Gauge – The thickness of the steel sheet. Counterintuitively, a lower gauge number means thicker, heavier steel. A 16-gauge deck is significantly thicker than a 22-gauge deck.

Composite deck – Designed to bond structurally with concrete, allowing the steel and concrete to act as a single unit.

Non-composite deck (Form Deck) – Serves as permanent formwork but does not bond structurally with concrete; the slab carries loads independently.

Galvanized coating (G60/G90) – Zinc coating that protects the steel from corrosion. G90 has 50% more zinc than G60.

Part 2: The First Major Decision – Composite vs. Non-Composite Deck

When specifying a steel floor deck system, one of the first decisions is whether composite or non-composite deck is required. This is not a matter of preference—it is a structural decision that your engineer of record will determine based on load tables, span requirements, and code compliance.

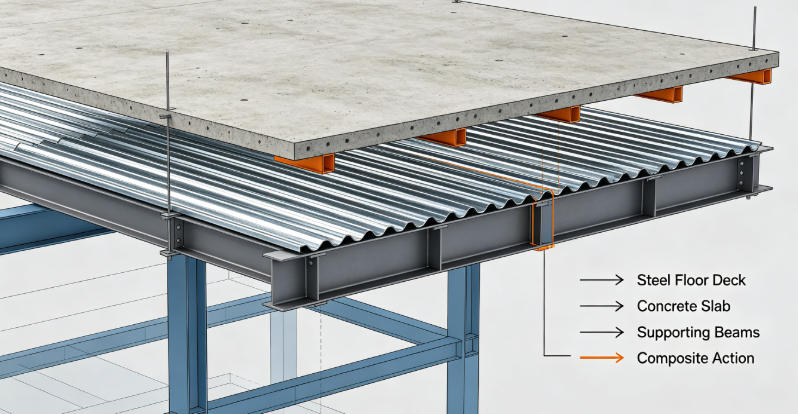

Composite metal deck (Type WR) is designed to bond structurally with the concrete poured on top. The deck's embossed ribs provide mechanical interlock with the cured slab, enabling composite action that allows longer spans, higher load capacities, and in most applications, eliminates the need for temporary shoring during construction. Common profiles are 1.5", 2", and 3" depth, with the 2" profile being the most widely specified for commercial multi-story work. Composite deck is typically specified for multi-story office buildings, hospitals, high-rise residential construction, and any project where shoring elimination is a schedule priority.

Non-composite metal deck (Type WF) serves as permanent steel formwork for concrete slabs. The key distinction: it does not bond structurally with the cured concrete. The deck stays in place permanently after the pour—no stripping required—but structurally the slab and deck are treated as separate elements. Non-composite deck is the right choice when composite action is not structurally required: ground-floor slabs, parking structures, industrial mezzanine systems, building renovations with existing framing constraints, and warehouses with heavy point loads.

Critical buying tip: Do not substitute one for the other. Choosing incorrectly can mean structural underperformance or unnecessary cost on your project. Always confirm with your structural engineer which type is specified in the design documents.

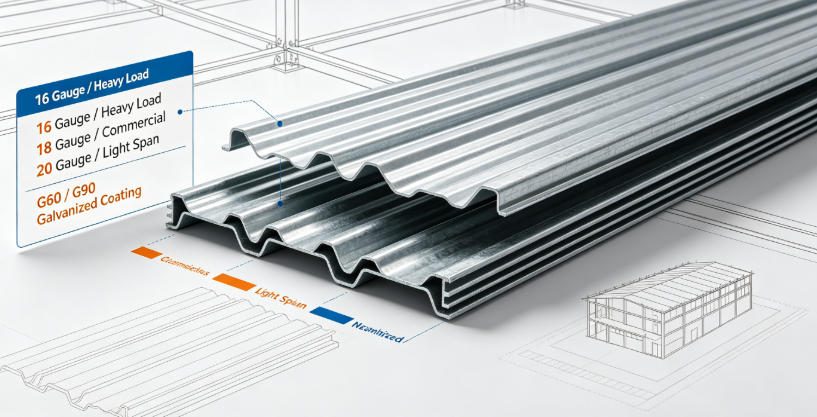

Part 3: Gauge Selection – Thickness Determines Strength

Steel deck gauge is one of the most common specification questions contractors and engineers ask when sourcing deck material. The gauge determines sheet thickness, which directly affects load capacity, allowable span, and the overall weight of the structure.

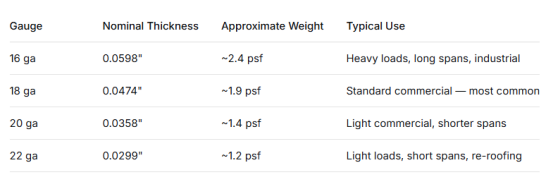

Published nominal thicknesses (per Steel Deck Institute standards):


Source: SDI standards

16 gauge is specified for heavy industrial applications, long clear-span layouts, or projects where vibration control is a structural concern. Common applications include large-span industrial warehouses, mechanical equipment rooms, and heavy manufacturing floors.

18 gauge is the most commonly specified gauge for commercial construction. It hits a balance between structural capacity and cost for typical office buildings, retail centers, schools, and healthcare facilities.

20 gauge is appropriate for lighter loads and shorter spans—smaller commercial projects, low-slope roofing systems, and applications where dead load reduction is a design goal.

22 gauge is the thinnest standard gauge, used for very short spans, light re-roofing overlays, and applications with minimal load requirements.

Critical buying tip: Always use published SDI load tables for structural design—consult your engineer of record for project-specific span and load requirements. The SDI publishes load tables that give allowable uniform loads for each combination of deck profile, gauge, and span. As a general principle: thicker gauge = longer allowable spans and higher allowable loads for a given profile.

Steel grade matters as much as gauge. Most structural designs reference Grade 33 or Grade 50 steel. Grade 50 steel—with higher yield strength—means the same gauge sheet carries more load or spans a greater distance than Grade 33 of identical thickness.

Part 4: Galvanized Coating – G60 vs. G90 and Why It Matters

When reviewing steel deck specifications or purchasing orders, you will encounter the designations G60 and G90. These refer to the zinc coating weight applied during the galvanizing process, and they directly affect the deck's long-term corrosion resistance.

The "G" designation comes from ASTM A653, the standard specification for hot-dip galvanized steel sheet:

G60: 0.60 oz/ft² total zinc coating (both sides combined)

G90: 0.90 oz/ft² total zinc coating (both sides combined)

G90 has 50% more zinc than G60. More zinc means a thicker protective barrier against moisture, oxygen, and chlorides—the primary drivers of steel corrosion.

When G60 is sufficient: G60 is specified for interior applications in dry, conditioned environments—most commonly 1.5" B roof deck in a standard commercial building where the deck will be covered by insulation and a roofing membrane immediately after installation.

When G90 is required or preferred: G90 is the standard coating for composite and non-composite floor deck. The reasoning: floor deck is exposed to wet concrete during the pour, creating an alkaline environment that can accelerate zinc consumption. G90 is also the appropriate choice for roof deck in coastal or high-humidity regions, any application where the deck will experience extended exposure before enclosure, parking structures where de-icing salts or moisture intrusion are expected, and industrial facilities with process moisture or chemical vapor exposure.

Critical buying tip: Structural drawings and project specs typically call out the galvanizing requirement in the steel deck specification section. Look for language like "galvanized per ASTM A653, G90 minimum" or a direct reference to the SDI standard. If the spec is silent on coating weight, confirm with the structural engineer of record before ordering—specifying G60 where G90 is intended is a field issue you want to avoid.

Open Type Floor Decking HY51-250-750 - HongYe

Part 5: Profile Selection – Matching Deck to Application

Different deck profiles are designed to handle specific conditions. The three major categories are:

Composite Floor Deck – Used in multi-story building construction where composite action is required. Available in 1.5", 2", and 3" rib depths. The 2" profile is the most widely specified for commercial multi-story work.

Form Deck (Non-Composite) – Used in floor applications where a bond between steel and concrete is not necessary. Often used in multi-story buildings, stair landings, and similar structures.

Roof Deck – Wider ribs at 1.5 to 7.5 inches, used for low-slope commercial roofs. Not interchangeable with floor deck despite similar appearance.

Profile depth and application matching:

Shallow decks (55mm depth, e.g., MF55, CF51, R51): Short-span and light-duty projects like flats, refurbs, or small office fit-outs. Fire resistance: 60 minutes. Acoustic: STC ~47-50dB.

Mid-depth decks (60mm depth, e.g., MF60, CF60, TR60): Balance between span, strength, and economy—ideal for typical commercial, institutional, and multi-residential properties. Fire resistance: 90 minutes. Acoustic: STC ~50dB.

Deep decks (80mm depth, e.g., MF80, CF80, TR80): Designed for long spans or high load demands—warehouses, open-plan offices, car parks. Fire resistance: 120 minutes. Acoustic: >52dB STC.

Critical buying tip: Deeper decks mean greater fire resistance and can reduce reinforcement requirements. Always consult the relevant manufacturer tables and SCI P360 to confirm fire performance for your slab build-up.


Part 6: Cost Considerations – What You Actually Pay

Steel deck pricing isn't fixed. Profile type, gauge, coating, quantity, and shipping all play a role, which is why you won't see set pricing listed online. Steel prices fluctuate, sometimes frequently, and that affects every project.

Typical per-square-foot ranges: A common gauge deck might land somewhere around $1.50 per square foot before freight is added. That number can move up or down depending on gauge, profile, and current steel pricing. For residential additions and ADUs, 1.5VLI or 2VLI composite deck in 20 gauge typically runs $1.40 to $2.50 per square foot in material cost.

Shipping plays a major role: Steel deck is delivered on trucks, and freight costs are real. It may cost roughly the same to ship one piece of deck as it does to ship one hundred pieces. Full truckloads are usually the most economical; smaller orders may have a higher cost per square foot.

Cut lengths and additional costs: Standard deck lengths are more efficient to produce. Pieces under eight feet typically include a cut charge. That doesn't mean short pieces are wrong—ordering deck cut to the correct length reduces jobsite labor, improves accuracy, and minimizes material waste.

Critical buying tip: Always provide exact dimensions when possible. Engineers will often break a building into sections—elevator shafts, mechanical areas, corridors—each with different lengths. When deck is ordered to match those dimensions, waste is reduced, installation is faster, and the deck performs as designed.

Global context: China's steel structure building market reached approximately RMB 450 billion in 2025, with steel structure production expected to reach approximately 111.18 million tons. The global structural steel fabrication market is projected to grow at a CAGR of around 4.2% through 2035. These trends reflect increasing reliance on steel structures worldwide, making informed purchasing decisions more important than ever.

Part 7: Supplier Selection – Beyond Price

Selecting the right supplier requires more than comparing quotes. Procurement teams must assess technical capability, responsiveness, consistency, and risk mitigation practices.

What to look for:

Technical compliance and material standards: Ensure the manufacturer uses high-strength cold-rolled steel with galvanized (G60–G90) coatings compliant with ASTM A653 or equivalent standards. Coating weight should be verified via mill test certificates (MTCs), which provide traceability across batches.

Certifications and ratings: Engineers look for manufacturers whose products carry UL fire ratings, FM approvals, and evaluation reports. Decking must meet ASTM standards and be available in multiple gauges and grades.

Operational reliability: On-time delivery rates above 97%, fast response times, and third-party inspection readiness indicate operational discipline.

Customization and engineering support: Project-specific designs require flexibility in profile shape, length, thickness, and coating. Leading suppliers accept CAD drawings and support sample prototyping.

Critical buying tip: Avoid full upfront payments. Use milestone-based terms: 30% deposit, 40% upon production completion (with photo/video proof), and 30% before shipment. Require pre-production samples before full rollout.

Part 8: Installation Planning – What to Know Before You Buy

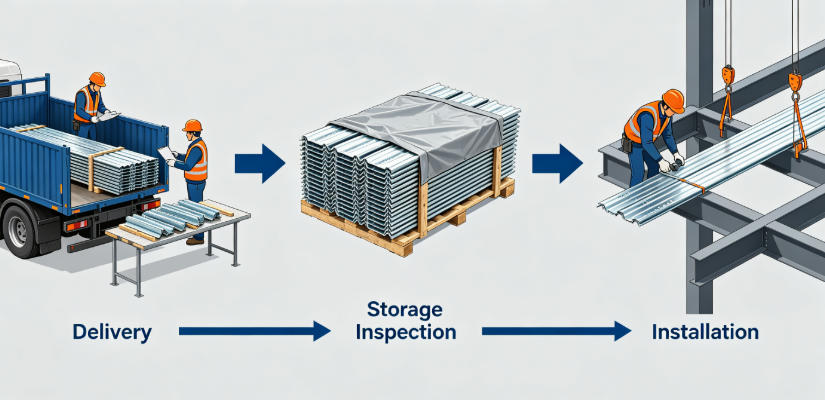

Material delivery and storage: Use wood blocking or pallets to prevent moisture contact. Cover deck bundles with tarps if exposed to weather.

Safety and fall protection: Prior to commencement of deck installation, a system of fall protection and safe access must be in place. Edge protection must be installed prior to decking installation commencing to all edge beams, voids, and openings.

Fastening and overlaps: Always follow the fastening pattern outlined in the shop drawings, whether that involves welding, screws, or mechanical fasteners. End laps should meet the specified overlap length on supports, and side laps must be properly nested or button-punched to prevent separation.

Urban jobsite considerations: Space is often limited in urban environments. There's no lay-down room to deliver full trucks, so more frequent and smaller deliveries may be required. If temporary shoring is required, make sure everyone coordinates and that all is in place before deck installation starts.

BIM and technology: The introduction of Building Information Modeling has completely changed construction coordination. Using 3D modeling, teams can spot and fix potential issues before construction even starts—avoiding costly mistakes and keeping installation smooth and on schedule.


Conclusion: Making the Right Choice for Your Project

Choosing the right steel floor deck isn't just about picking a material—it's about ensuring your project meets its structural goals, stays on schedule, and delivers value over time. The decisions you make—composite vs. non-composite, gauge selection, coating specification, profile matching, supplier selection—each play a critical role in the success of your building project.

The global steel structure industry continues to grow, driven by urbanization, infrastructure investment, and the inherent advantages of steel construction—speed, strength, sustainability, and cost-effectiveness. Steel structures can be recycled at rates exceeding 80%, aligning with circular economy principles. With proper specification and procurement, your steel floor deck will provide decades of reliable service.

Final checklist before purchasing:

Confirm composite vs. non-composite with your structural engineer

Verify gauge and grade per SDI load tables

Specify G90 galvanized for floor deck applications

Match profile depth to span, load, fire, and acoustic requirements

Obtain current pricing including freight and cut charges

Select a supplier with certifications, reliability, and engineering support

Plan delivery and installation logistics in advance

By following these critical buying tips, you will be well-equipped to source the right steel floor deck for your next building project—on time, on budget, and built to last.

Durable HY51-253-760 Steel Structure from China manufacturer - Anhui Hongye Steel Structure Co., Ltd.



Quick Links

Product Category

Contact Us

+86-13637029045 / +86-19855001888
 13665213274@163.com .
     zjuzheng136@gmail.com
 Zone A, Industrial Park, Chajian Town, Tianchang City, Anhui Province
Copyright © 2025 Anhui Hongye Steel Structure Co., Ltd. All Rights Reserved I Sitemap I Privacy Policy
